A second story addition is a vertical home expansion that places a fully framed new floor on top of your existing structure, requiring engineered load transfers, foundation assessment, permits, and phased construction. Understanding how second story addition works before you commit saves you from costly surprises mid-project. This guide covers every phase, from structural engineering through final inspection, along with realistic cost ranges and the design challenges most homeowners never see coming.
What are the main structural and engineering considerations?
A second story addition transfers significant new weight through your existing walls, beams, and foundation. Structural engineers confirm that skipping a professional structural assessment often leads to failures when walls are opened during construction. That is not a risk worth taking.

The role of a structural engineer is to evaluate whether your current foundation, wall framing, and beam sizes can carry the added load. In many Houston homes built before the 1990s, the answer is “not without upgrades.” Foundation inspections sometimes require cutting into slabs to verify footing depth and strength, which can trigger reinforcement work before a single framing nail goes in.
Beyond vertical loads, your second floor diaphragm must be physically tied into the first floor framing to handle lateral forces like wind and seismic movement. This requires blocking and special metal hardware installed before drywall goes up. Most homeowners never hear about this step until their contractor explains why the framing phase takes longer than expected.
- Foundation capacity check: Verify footings can carry the added dead and live load
- Wall framing assessment: Identify load-bearing walls that need headers or posts upgraded
- Beam sizing review: Confirm existing ridge beams and floor joists meet span requirements
- Lateral bracing plan: Add blocking and metal connectors to tie floors together
Pro Tip: Many homeowners assume the second story simply “sits” on top of the roof. It does not. The roof is removed entirely, and the new floor system is framed directly onto the reinforced first-floor walls. Knowing this helps you plan for the temporary weatherproofing costs that come with it.
What does the typical timeline and construction process look like?
The second story addition process moves through five distinct phases, each with its own inspection gates and dependencies. Full additions typically require 6–12 months, while partial additions covering one section of the roof can be completed in roughly half that time. Rushing any phase creates rework that costs more than the time saved.

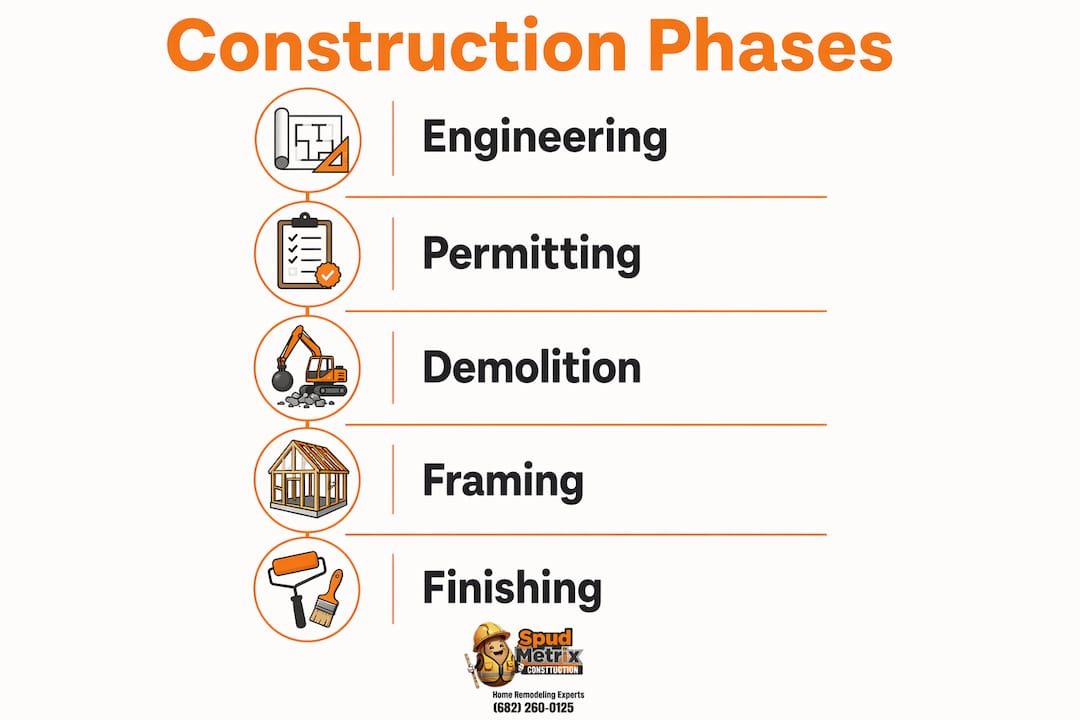

Here is how the phases sequence:
- Engineering and design (4–8 weeks): Structural engineer completes load analysis; architect produces permitted drawings; exploratory openings confirm wall and footing conditions before final plans are locked.
- Permitting (4–12 weeks): Plans submitted to the local building department; second story permits are more involved than ground additions due to height, setback, and structural changes, so expect longer review cycles and possible revision requests.
- Framing and shell (4–8 weeks): Roof removed, new floor system framed, exterior walls built, roof reconstructed, and windows installed. This phase ends with the critical framing inspection.
- Mechanical rough-ins (3–5 weeks): Plumbing, electrical, and HVAC rough-in work begins only after the framing inspection passes. No rough-in work can legally proceed until structural components receive approval.
- Finishing (6–10 weeks): Insulation, drywall, flooring, trim, fixtures, and final inspections close out the project.
| Phase | Typical Duration | Key Milestone |
|---|---|---|
| Engineering and design | 4–8 weeks | Structural drawings approved |
| Permitting | 4–12 weeks | Building permit issued |
| Framing and shell | 4–8 weeks | Framing inspection passed |
| Mechanical rough-ins | 3–5 weeks | Rough-in inspections passed |
| Finishing | 6–10 weeks | Certificate of occupancy issued |
Pro Tip: Build two extra weeks into your permit timeline from the start. Re-inspection delays after framing corrections are the single most common reason second story projects run over schedule.

How much does a second story addition cost?
The cost of a second story addition runs $100–$300 per square foot, with full projects ranging from $250,000 to $750,000. A simpler single-room addition starts around $65,000. Those numbers reflect real variation driven by structural conditions, finish selections, and how much of the existing home needs upgrading.
Older homes consistently cost more. Systems like electrical panels, plumbing supply lines, and HVAC equipment that were sized for a single story need replacement or expansion when a second floor is added. That work adds cost even before framing begins.
The investment case is real. Second story additions increase resale value by 15%–20%, and homeowners recoup roughly 65% of construction costs at sale. That return is especially strong in Houston neighborhoods where lot sizes limit horizontal expansion.
Key factors that push costs higher:
- Foundation reinforcement: Older footings that require underpinning or new piers
- Structural upgrades: Replacing undersized beams, headers, and load-bearing walls
- System replacements: Electrical panel upgrades, new HVAC equipment, and plumbing rerouting
- Finish level: Custom millwork, tile, and fixtures versus builder-grade selections
- Site access: Tight lots that complicate crane or material delivery logistics
Budget a 10%–15% contingency on top of your contractor’s estimate. Structural surprises discovered after walls open are the most common source of overruns on second level home expansion projects.
What design and practical challenges should homeowners expect?
Staircase placement is the design problem that catches most families off guard. You need roughly 80–100 square feet of first-floor space to fit a code-compliant staircase, and that space has to come from somewhere. Stacking new stairs directly above existing basement stairs saves 40–50 square feet and preserves first-floor flow better than any other placement strategy.
HVAC is the other major challenge. Original furnace blower motors are not sized for a second floor and will overwork and fail without an upgrade. A dual-zone, high-efficiency system is the standard solution. It controls temperature independently on each floor, which matters in Houston’s climate where heat rises and upper floors can run 8–10 degrees warmer without proper zoning.
- Staircase options: Straight run, L-shaped, or switchback designs each trade square footage for headroom differently
- HVAC zoning: Separate thermostats and dampers for each floor prevent the upper level from becoming uncomfortable
- Roofline integration: New roof pitch must match or complement the existing structure to avoid an awkward visual break
- Partial addition designs: Adding a second story over one wing only reduces cost and disruption while still gaining meaningful space
Pro Tip: Modular second story additions, built off-site and craned into place, can reduce on-site construction time and weather exposure. Ask your contractor if your project footprint and site access make this approach feasible.
What permitting, zoning, and regulatory steps are involved?
Second story permits are more complex than permits for ground-level additions. Building departments review structural drawings, height calculations, and setback compliance before issuing approval. Local building codes commonly limit maximum allowable height and impose setback requirements from property lines. Starting your permit research early can prevent redesigns that cost thousands.
The permitting process for a residential addition in most Texas jurisdictions involves submitting architectural and structural drawings, a site plan showing setbacks, and energy compliance documentation. Houston’s building department reviews these in sequence, and any deficiency triggers a correction cycle that adds weeks.
Key regulatory checkpoints to plan for:
- Zoning compliance review: Confirm height limits and setbacks before finalizing design
- Plan check submission: Structural and architectural drawings reviewed by building officials
- Framing inspection: The critical gate that must pass before any mechanical work begins
- Rough-in inspections: Separate approvals for plumbing, electrical, and HVAC rough-in work
- Final inspection: Confirms all systems meet code before a certificate of occupancy is issued
Coordinate your contractor’s schedule around inspection availability. In busy permit seasons, inspection slots can run 5–10 business days out, and a failed inspection resets that wait entirely.
Key Takeaways
A second story addition works by reinforcing your existing structure, removing the roof, framing a new floor system, and completing phased construction through engineering, permitting, mechanical, and finishing stages.
| Point | Details |
|---|---|
| Structural assessment is non-negotiable | A licensed structural engineer must evaluate foundations and walls before any design is finalized. |
| Full additions take 6–12 months | Plan for a longer timeline than a standard remodel due to permitting, inspections, and phased sequencing. |
| Costs range widely | Budget $100–$300 per square foot, plus a 10%–15% contingency for structural surprises. |
| HVAC and staircase require early planning | Both affect first-floor layout and system sizing decisions that cannot be reversed cheaply later. |
| Resale value improves meaningfully | Homeowners typically recoup about 65% of costs at sale, with a 15%–20% increase in home value. |
What I have learned from second story addition projects
The biggest mistake I see homeowners make is treating a second story addition like a large remodel. It is not. It is closer to building a new home on top of an existing one, with the added complexity of working around a structure that is already occupied and load-bearing.
The structural assessment phase deserves more time and budget than most families give it. I have seen projects where exploratory wall openings revealed undersized beams that required complete redesigns of the structural plan. Catching that before permits are submitted saves weeks and real money. Catching it after framing starts is painful.
Staircase design is the decision I push clients to make first, not last. Where the stairs land determines how the entire first floor lives after construction. Families who treat it as an afterthought often end up sacrificing a bedroom or a dining room to fit a compliant run.
My honest advice: view this project as a 10-year investment, not a 10-month construction job. The families who approach it that way make better decisions at every milestone, from finish selections to HVAC equipment grades. The ones who rush it to save money in the short term almost always spend more fixing problems later.
— Brandon
How Spudmetrix can help you build up with confidence
Planning a second story addition in the Houston area means navigating local zoning rules, Houston’s specific climate demands, and a permit process that moves on its own timeline. Spudmetrix manages every phase of that process for you, from the initial structural assessment through final inspection sign-off.

Spudmetrix’s team coordinates directly with structural engineers, building officials, and trade contractors so nothing falls through the cracks between phases. If you are ready to explore what adding a second floor could look like for your home, start with a free in-home consultation from Spudmetrix. For a broader look at what the full construction process involves, the remodeling project phases guide is a strong next read.
FAQ
How long does a second story addition take?
Full second story additions take 6–12 months, while partial additions over one section of the home can be completed in roughly half that time. Permitting and inspection delays are the most common causes of schedule extensions.
Does my foundation need to be replaced for a second story?
Not always, but it must be professionally assessed. Foundation inspections sometimes require cutting into slabs to verify footing depth, and reinforcement work is common in older homes before structural framing can begin.
What is the average cost to add a second story?
Costs run $100–$300 per square foot, with full projects ranging from $250,000 to $750,000. Single-room additions start around $65,000. Older homes cost more because electrical, plumbing, and HVAC systems typically need upgrades alongside the structural work.
Do I need a structural engineer for a second story addition?
Yes. Structural engineers assess load transfers through existing walls and foundations, and their stamped drawings are required by building departments before a permit is issued.
Can I stay in my home during a second story addition?
It depends on the scope. Full additions require roof removal, which makes living in the home impractical and potentially unsafe during the framing phase. Partial additions over one wing may allow occupancy with proper temporary weatherproofing in place.
