Contractor overhead costs are the indirect business expenses a contractor must pay to keep their company running, regardless of whether any project is active. Think office rent, insurance premiums, vehicle payments, and administrative salaries. These costs are real, legitimate, and they belong in every bid you receive. Industry sources show overhead commonly runs a significant portion of revenue depending on company size. The single most protective step you can take before signing anything: request a written, line-item estimate that shows how overhead is allocated, not just a lump-sum total.
Table of Contents
- How overhead differs from direct job-site costs
- What overhead line items actually cover
- How contractors calculate and apply overhead to a bid
- What overhead rates typically look like for residential contractors
- Why opaque overhead creates real project risks
- Questions to ask when comparing bids
- Worked example: overhead from company books to your bid
- How permits and insurance appear in estimates
- Key Takeaways
- What transparent overhead actually tells you about a contractor
- Ready to see what a transparent estimate looks like?
- Useful sources for further reading
How overhead differs from direct job-site costs

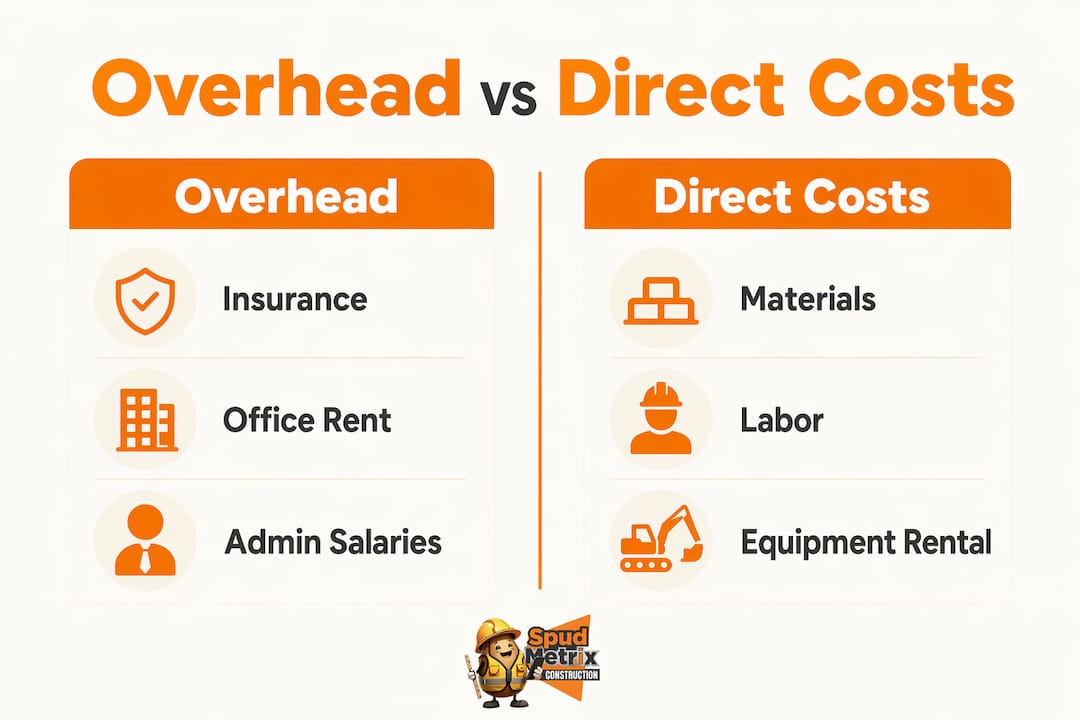

Direct costs are expenses that exist only because your specific project exists: materials purchased for your kitchen, on-site labor hours, subcontractor fees, and permit fees tied to your job address. Overhead is everything else. The simplest test is this: if the cost would exist even with zero active projects, it is overhead.
Common direct costs:
- Materials (lumber, tile, fixtures)
- On-site labor wages for your project
- Subcontractor fees (plumber, electrician)
- Job-specific permit fees
Common overhead costs:
- Office rent and utilities
- Owner’s administrative time and salary
- Vehicle payments and fleet maintenance
- Software subscriptions and field management tools
- General liability and workers’ comp insurance
- Marketing and advertising
Variable overhead such as fuel, vehicle maintenance, and owner admin time is the category most often missed. When a contractor skips it, their overhead rate looks artificially low, and that gap shows up later as a change order.
Pro Tip: Many contractors exclude the owner’s own salary from overhead, treating it as profit. That is a common mistake. If the owner handles estimating, scheduling, or client communication, that time has a real cost and belongs in overhead.

What overhead line items actually cover
Understanding the specific line items helps you verify that a contractor’s estimate is complete, not just competitive.
- General liability and workers’ comp insurance: Protects you if a worker is injured or property is damaged. Ask for a certificate of insurance (COI) before work starts.
- Office rent and utilities: Fixed monthly costs that exist whether the crew is on your job or not.
- Vehicle and equipment depreciation: Trucks and tools wear out. Contractors who don’t account for replacement costs eventually cut corners to fund them.
- Administrative payroll burden: Payroll taxes, health benefits, and paid time off on top of base wages. This is often hidden in estimates but materially raises the true cost of labor.
- Software and subscriptions: Project management platforms, accounting tools, and scheduling apps.
- Marketing and professional fees: CPA, legal counsel, licensing renewals, and advertising.
- Bonding and licensing: Required in most U.S. jurisdictions; confirm the contractor holds current licenses for your trade.
If any line item is unclear, ask for supporting documentation: a COI for insurance, a permit-holder confirmation for permits, or a fee schedule for professional services.
How contractors calculate and apply overhead to a bid
Two formulas cover most residential contractor pricing:
Overhead rate (% of revenue):
Overhead Rate = Total Annual Overhead ÷ Total Revenue × 100
Overhead per labor hour:
Overhead per Hour = Total Annual Overhead ÷ Total Billable Hours
Both methods are legitimate. The percentage method is simpler; the per-labor-hour method is more precise because it ties overhead recovery directly to how much labor a project actually consumes.
| Method | What it needs | Best for |
|---|---|---|
| % of revenue | Annual P&L totals | Quick estimates, smaller firms |
| % of direct costs | Job cost breakdown | Mid-size residential projects |
| Overhead per labor hour | Time tracking data | Labor-intensive remodels |
Mini walk-through using the per-hour method:
- Total annual overhead: $120,000
- Estimated billable hours for the year: 2,400
- Overhead per hour: $120,000 ÷ 2,400 = an overhead rate per hour
- Project requires 200 labor hours: 200 × $50 = an overhead allocation amount calculated from multiplying overhead rate by labor hours
- That $10,000 appears as a line item in your bid alongside direct labor and materials.
Pro Tip: Ask whether the contractor uses burdened labor rates — wages plus payroll taxes, insurance, and benefits — before applying overhead. A contractor who skips this step systematically underprices labor and will eventually make up the difference somewhere in your project.

What overhead rates typically look like for residential contractors
Benchmarks by company size give you a realistic range to compare against any bid you receive:
- Solo operators: 25%–35%
- Small firms (2–10 employees): 30%–40%
- Mid-size firms: 35%–45%
- Larger established firms: 40%–54%
A bid with unusually low overhead is a warning sign, not a bargain. It usually means the contractor is underpricing, which leads to change orders, material substitutions, or, in the worst cases, project abandonment when cash runs short.
Factors that push overhead higher include a large fleet, dedicated office staff, active warranty programs, high insurance premiums in specialized trades, and debt service on equipment. A sitework contractor like Barnhart Excavating carries heavier equipment costs than a finish carpenter, so their overhead structure looks meaningfully different even on similar-sized projects.
Why opaque overhead creates real project risks
Financial experts warn that contractors without a written overhead recovery strategy tend to fund business costs from project profit. When that happens, you feel it as a homeowner.
Common failure modes:
- Change orders that appear mid-project with no clear scope change
- Unexplained delays while the contractor juggles cash across jobs
- Material substitutions (cheaper tile, thinner drywall) to recover margin
- Project abandonment when the contractor runs out of working capital
Here is how it plays out in practice: a contractor wins your $60,000 kitchen remodel with a 12% flat markup, assuming that covers overhead. Midway through, they realize their true overhead rate is closer to 35%. To recover, they submit a $4,800 change order for “unforeseen conditions” that were entirely foreseeable. You pay it because stopping the project costs more.
Pro Tip: Before signing, ask the contractor whether they use centralized cost-tracking software rather than ad-hoc spreadsheets. Contractors who track real-time job costs produce fewer surprise overages. Also request a written change-order policy that defines what triggers a change order and requires your written approval before any additional work begins.
Budgeting for unexpected remodel costs is always smart, but a transparent contractor minimizes how often you need that contingency.
Questions to ask when comparing bids
Use this checklist before accepting any estimate:
- “Can you provide a line-item estimate that separates materials, labor, overhead, and profit?”
- “What is your overhead rate, and which expenses does it include?”
- “Do your labor rates include payroll burden (taxes, insurance, benefits)?”
- “Who pulls the permits, and is that cost included in this estimate?”
- “Can I see your current certificate of insurance and workers’ comp documentation?”
- “What is your change-order policy, and will I receive written approval requests before any additional work begins?”
A thorough bid comparison goes beyond price. It looks at what each number actually covers.
Red flags to watch for:
- All-in flat bids with no cost breakdown
- Refusal to share a COI or proof of workers’ comp
- Unit rates that shift unexplained between bids for identical scope
- Vague change-order language (“additional work billed at cost”)
Worked example: overhead from company books to your bid
Project: Bathroom remodel, direct costs only
| Cost category | Amount |
|---|---|
| Materials | $10,000 |
| Direct cost subtotal | $15,000 |
Applying overhead (35%) and profit (15%):
- Overhead: $15,000 × 35% = $5,250
- Subtotal with overhead: $15,000 + $5,250 = $20,250
- Profit: $20,250 × 15% = $3,038
- Final bid: $23,288
Now compare what happens when a contractor underestimates overhead at 15% instead of 35%:
| Scenario | Overhead applied | Final bid | Shortfall |
|---|---|---|---|
| Accurate (35%) | $5,250 | $23,288 | — |
| Underestimated (15%) | $3,038 | $23,288 | $3,000+ |
That $3,000+ gap is exactly where mid-project change orders come from.
How permits and insurance appear in estimates
Permit fees are typically passed through as direct costs: the contractor pays the municipality and invoices you at cost or with a small administrative fee. General liability and workers’ comp, by contrast, are overhead because they cover the entire business year, not just your project.
Documents to request before work begins:
- Certificate of insurance (COI) showing general liability and workers’ comp coverage
- Permit receipts or permit-holder confirmation (in most U.S. jurisdictions, the contractor must pull permits, not the homeowner)
- Proof of current state contractor’s license
- Bond documentation if the project scope or your jurisdiction requires it
In Texas, the contractor is generally responsible for obtaining the required permits. Confirm in writing whether permit costs are included in your estimate or invoiced separately. More detail on how this works is covered in Spudmetrix’s guide to why permit costs appear in remodeling estimates.
Key Takeaways
Contractor overhead is a necessary, calculable business cost that should appear transparently in every written estimate you receive, with rates typically ranging from 25% to 54% depending on company size.
| Point | Details |
|---|---|
| Overhead vs. profit | Overhead covers business operating costs; profit is what remains after all costs, including overhead, are paid. |
| Typical rate ranges | Solo operators run 25%–35%; small firms typically range from 30%–40%; mid-size firms 35%–45%; larger established firms reach 40%–54%. |
| Burdened labor rates | Always ask whether labor rates include payroll taxes, insurance, and benefits before comparing bids. |
| Document checklist | Request a COI, permit confirmation, and a written change-order policy before signing any contract. |
| Spudmetrix approach | Spudmetrix provides free in-home consultations with written, line-item estimates that show overhead allocation clearly. |
What transparent overhead actually tells you about a contractor
Most homeowners focus on the bottom-line number when reviewing bids. That is understandable, but it is also where contractors with poor overhead accounting have the easiest time winning work they cannot profitably complete.
The overhead percentage is not just an accounting detail. It tells you whether a contractor has actually sat down and calculated what it costs to run their business, or whether they are pricing from gut feel and competitor rates. A contractor who cannot explain their overhead rate has almost certainly not calculated it properly. And a contractor who has not calculated it properly will eventually ask you to fund the gap.
The most reliable contractors I have seen operate with documented overhead, burdened labor rates, and centralized cost tracking. They are rarely the lowest bid. But they are the ones who finish projects on budget, pull permits without being asked twice, and send change-order requests with clear scope documentation rather than vague invoices.
Ask for the breakdown. If a contractor hesitates, that hesitation is the answer.
Ready to see what a transparent estimate looks like?
Spudmetrix serves Houston homeowners and investors with free in-home consultations and written, line-item estimates that separate materials, labor, overhead, and profit clearly. No vague markups. No surprise change orders mid-project. Permits and inspections are managed as part of the service, so you are never left guessing who is responsible for what.

Before you sign with any contractor, review the questions to ask before hiring and use the interior remodel planning checklist to prepare a clear project scope. Both resources help you compare bids on equal footing. When you are ready to talk through your project, contact Spudmetrix to schedule your free consultation.
This article is general information for educational purposes. Confirm current licensing, permit, and insurance requirements with your local jurisdiction and a qualified contractor before starting any project.
Useful sources for further reading
- Contractor Overhead Calculator (Harvest): An interactive calculator that walks contractors and homeowners through overhead categories and produces an overhead rate; useful for sanity-checking a bid’s overhead percentage.
- How to Calculate Construction Overhead (Level Accounting Firm): Explains fixed vs. variable overhead, the risk of undercounting, and why a written overhead recovery strategy matters for project completion.
- Construction Overhead Costs Guide (Projul): Covers the main allocation methods (% of revenue, % of direct costs, per labor hour) with formulas homeowners can use to verify estimates.
