A fair remodel payment schedule is defined as a structured series of milestone-based payments that limits your upfront exposure, ties each release to verified work, and holds back a final amount until the project is complete. Getting this structure right is the single most important financial decision you make before a contractor picks up a single tool. Most homeowners focus on the total price. The ones who avoid costly disputes focus on when and why each dollar moves.
Industry standards for negotiating a fair remodel payment schedule recommend limiting deposits to 10–25% of the total contract price. For mid-sized remodels in the $15,000–$60,000 range, a common structure runs 10% down, 30% at framing completion, 30% at drywall, and 30% at final punch list sign-off. That structure keeps your money working as leverage, not as a gift to a contractor who may have three other jobs running simultaneously.
What are the common milestones in a remodel payment schedule?
A milestone-based draw schedule tied to verifiable completion stages is the most reliable risk-control tool available to homeowners. Each payment should correspond to a specific, observable point in the project, not a date on a calendar.

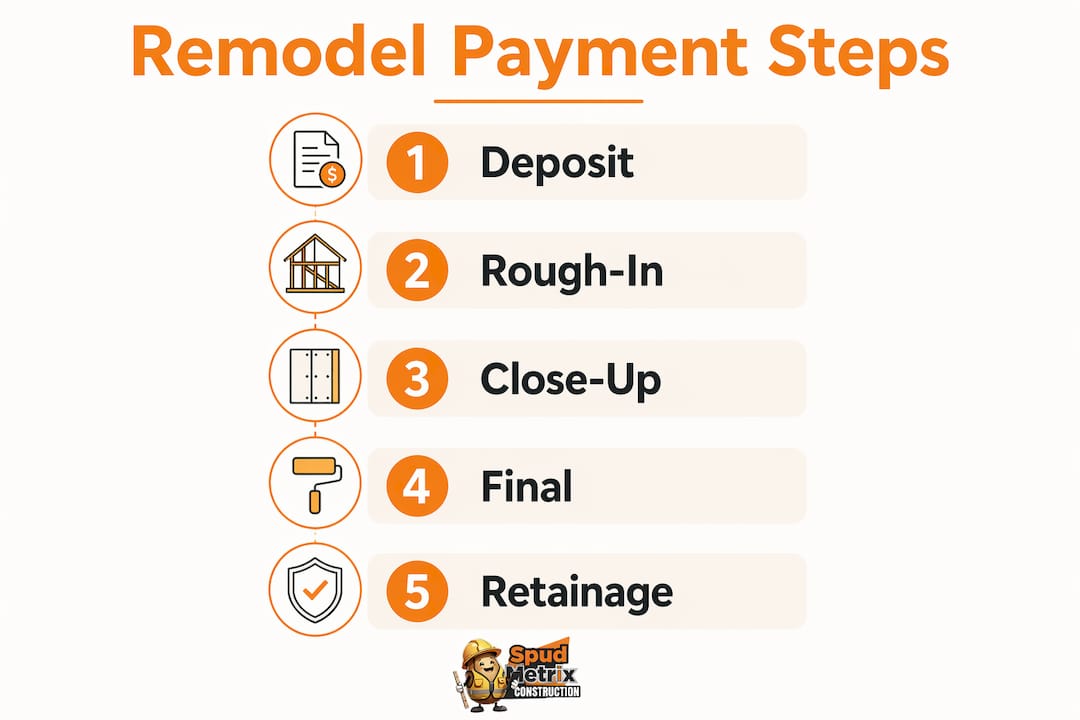

Typical milestones for a full interior remodel include:
- Mobilization deposit: Covers material procurement and project startup. Cap this at 10–15% of the contract value.
- Demo and rough-in complete: Structural work, rough plumbing, and rough electrical are done and ready for inspection.
- Close-up complete: Insulation, drywall hung and taped, and any required inspections passed.
- Finish stage: Flooring, cabinetry, trim, fixtures, and paint are installed and visually complete.
- Final draw: Released only after a walkthrough, punch list sign-off, and all contractual finish conditions are met.
Milestones need to match your specific project scope. A bathroom remodel has different natural checkpoints than a full kitchen gut. Work with your contractor to define each milestone in writing before you sign anything. Vague language like “substantial completion” is not a milestone. “Drywall hung, taped, and first coat of mud applied” is.
Verification is where most homeowners skip a step. Before releasing any draw, conduct a walkthrough or request photos. For larger projects, schedule a third-party inspection at key stages, particularly before close-up, when defects get buried behind drywall. Lien waivers from subcontractors and suppliers are another layer of protection. Request a conditional lien waiver with each draw and an unconditional one at final payment. This confirms that the people who actually did the work have been paid, which protects you from liens filed against your property.
Pro Tip: Link your project timeline milestones directly to your payment triggers. If the framing inspection fails, the framing draw does not release. Put that logic in writing.

How do you negotiate fair payment terms with contractors?
Payment negotiation is a give-and-take process. You can offer faster invoice approvals in exchange for milestone-based payment terms that preserve your leverage through the final stages of the project. Contractors value predictable cash flow. You value accountability. A well-structured schedule gives both parties what they need.

Start by setting a firm deposit ceiling. Contractors requesting more than one-third of the contract value upfront often signal undercapitalization. That money frequently funds other jobs, not yours. A 10–15% deposit is reasonable for material procurement. Anything above 25% warrants a direct conversation about why.
Red flags to watch for during negotiation:
- Requests for a deposit exceeding 30% of the total contract price
- Payment triggers defined by dates rather than completed work
- Pay-when-paid clauses that tie your payment releases to the contractor’s receipt of funds from other parties
- Vague milestone definitions like “project is progressing well”
- Resistance to lien waivers or third-party inspections
Change orders deserve their own payment terms, separate from the base draw schedule. Document every change order with a written scope, cost, and schedule impact before any additional work begins. Blending change order costs into regular milestone payments creates confusion and erodes your ability to track what you are actually paying for.
For larger projects, consider using an escrow service. Escrow holds milestone funds until you approve the work, giving the contractor visibility of available funds while keeping disbursement control in your hands. This structure reduces the risk of contractor abandonment mid-project and gives both parties a neutral mechanism for dispute resolution.
Pro Tip: Ask your contractor to provide a schedule of values before signing. This document breaks the total contract price into line items by phase. It makes milestone verification far more objective and harder to dispute.
What legal protections belong in a remodel payment schedule?
A payment schedule without legal teeth is just a wish list. The contract language surrounding your payment terms determines whether you can actually enforce them. Vetting your contractor’s contract before signing is as important as negotiating the numbers themselves.
Key contractual protections to include:
- Right to withhold payment: You retain the right to withhold a draw if the corresponding milestone is incomplete or deficient, without penalty or interest.
- Right to cure: The contractor has a defined period, typically 10–14 days, to correct deficient work before you can engage another party.
- Fixed payment timeframes: Specify that draws are released within a set number of days after milestone approval, such as within 10 days. This prevents open-ended payment cycles.
- Lien waiver requirements: Each draw requires a conditional lien waiver from the contractor and any major subcontractors.
- Punch list holdback: Define a specific dollar amount, typically 5–10% of the contract, held until the punch list is fully resolved.
- Formal dispute notice: Require written notice before either party can claim a breach, giving both sides a chance to resolve issues without litigation.
In some jurisdictions, statutory holdbacks apply regardless of what your contract says. In Ontario, for example, a 10% statutory holdback applies to every payment, released 60 days after substantial completion if no liens are filed. While this specific rule applies in Canada, many U.S. states have analogous lien law protections that affect how and when you can safely release final payment. Check your state’s contractor licensing board or consult a construction attorney if your project exceeds $50,000.
Remodeling contracts in 2026 increasingly include digital approval workflows that timestamp milestone sign-offs. This creates a clear paper trail and removes ambiguity about when a payment obligation was triggered.
Common mistakes homeowners make with remodel payment schedules
Most remodel payment problems are predictable. They follow the same patterns, and they are almost always avoidable with better preparation before the project starts.
Agreeing to a large upfront deposit without justification. Ask the contractor to itemize what the deposit covers. If they cannot explain it in terms of specific materials or startup costs, the number is arbitrary.
Paying for work that has not been verified. Never release a draw based on a contractor’s word alone. Walk the site, review photos, or schedule an inspection before approving any milestone payment.
Blending change orders into regular draws. This is the fastest way to lose track of your budget. Every change order is a separate financial event with its own approval and payment terms.
Skipping the punch list holdback. Contractors have little incentive to return for minor corrections once they have received full payment. A 5–10% retainage held until the punch list is resolved is your most effective finishing leverage.
Failing to define “complete” in writing. What does a completed kitchen look like? Specify it. Include appliance installation, hardware, touch-up paint, and cleanup. Ambiguity always costs money.
Ignoring the connection between inspections and payments. Inspections are not just a permit formality. They are objective, third-party confirmation that work meets code. Linking payment releases to passed inspections removes subjectivity from the process.
Pro Tip: Before signing any contract, read the payment schedule out loud and ask yourself: “What happens if the contractor misses this milestone?” If the contract does not answer that question clearly, rewrite the clause.
Key Takeaways
A fair remodel payment schedule protects your investment by tying every dollar to verified, milestone-based progress and holding back a final retainage until the punch list is fully resolved.
| Point | Details |
|---|---|
| Limit your deposit | Cap upfront payments at 10–25% of the total contract to preserve leverage and reduce risk. |
| Define milestones precisely | Write specific, observable completion conditions for each draw, not vague progress descriptions. |
| Require lien waivers | Collect conditional lien waivers with each draw and unconditional ones at final payment. |
| Hold back retainage | Keep 5–10% of the contract value until the punch list is fully signed off. |
| Separate change orders | Document every change with its own scope, cost, and payment terms, apart from base draws. |
Why I treat payment schedules as the real project plan
Most homeowners think the contract is the project plan. After years of working on remodels in Houston, I have come to believe the payment schedule is the actual project plan. The contract describes the work. The payment schedule determines whether that work actually happens in the right order, at the right quality level.
The contractors I have seen do the best work are the ones who welcome a structured draw schedule. They know their cash flow is predictable. They know the homeowner is engaged and paying attention. That dynamic produces better outcomes than a handshake and a large check ever will.
The emotional trap most homeowners fall into is wanting to be “easy to work with.” They agree to a bigger deposit than they should, they skip the walkthrough before releasing a draw, and they avoid the awkward conversation about the punch list holdback. That instinct to avoid friction is exactly what leads to unfinished trim and a contractor who stops returning calls.
Payment schedules function as accountability mechanisms, not just financial controls. When a contractor knows that the next $15,000 releases only after a passed inspection, they sequence their work differently. They show up. They finish. The schedule creates the behavior you want, without you having to ask for it.
The best negotiation outcome is not the lowest deposit. It is a schedule that both parties understand, that reflects the actual sequence of the work, and that leaves no ambiguity about what triggers each payment. That kind of clarity is worth more than any single dollar concession.
— Brandon
How Spudmetrix approaches remodel payment planning
Spudmetrix works with Houston homeowners and property managers who want payment schedules built around their actual project scope, not a generic template.

Every Spudmetrix project starts with a free in-home consultation and a detailed written estimate that breaks costs down by phase. That estimate becomes the foundation for a milestone-based payment schedule tied to real, inspectable progress points. Homeowners get written documentation of what each draw covers, what verification is required, and what the punch list holdback protects. For anyone who wants to understand what a solid remodeling contract looks like before sitting down with a contractor, Spudmetrix’s remodeling contract guide covers every clause that belongs in a fair agreement.
FAQ
What is a fair deposit for a remodeling project?
A fair deposit falls between 10% and 25% of the total contract price. Deposits above 30% are a recognized red flag and often indicate a contractor with cash flow problems.
How many milestones should a remodel payment schedule have?
Most mid-sized remodels use four to five milestones: a mobilization deposit, rough-in completion, close-up completion, finish stage, and a final draw after punch list sign-off.
What is retainage in a remodeling contract?
Retainage is a percentage of the contract value, typically 5–10%, withheld from the final payment until all punch list items are resolved and the homeowner approves the completed work.
Can I use escrow to manage contractor payments?
Yes. An escrow service holds milestone funds until you approve the completed work, giving the contractor visibility of available funds while keeping disbursement control with you.
What should I do if a contractor misses a milestone?
Issue a written notice specifying the deficiency and a cure period, typically 10–14 days. Withhold the corresponding draw until the milestone conditions are fully met, as defined in your contract.
