Remodeling sequence is the ordered, step-by-step progression of tasks required to complete a home renovation without costly mistakes or rework. Ignoring this order is the single most common reason projects run over budget and over schedule. The industry standard, often called construction sequencing, follows a physical dependency chain: structural work must precede mechanical systems, mechanical systems must precede insulation and drywall, and finishes come last. Every step in this chain exists because the work behind it physically cannot be undone without destroying what came after. Understanding why remodeling sequence matters puts you in control of your project before a single wall comes down.

Why remodeling sequence matters: the correct task order

The universally accepted remodeling sequence follows an “inside-out, structural-to-cosmetic” rule. Industry best practice places all rough-in trades, meaning plumbing, electrical, and HVAC, before any insulation, drywall, or finish work. Each phase depends on the one before it being complete and inspected.

Construction worker inspecting house framing structure

The table below shows the standard sequence and the reason each step comes where it does.

PhaseTaskWhy it comes here
1Site prep and demolitionClears the space; reveals hidden conditions before any new work begins
2Structural repairs and framingMust be solid before anything is attached to it
3HVAC rough-inBulky ductwork must route before plumbing and electrical to avoid conflicts
4Plumbing rough-inPipes set before walls close; inspections required before concealment
5Electrical rough-inWiring runs after plumbing to avoid routing conflicts
6Rough-in inspectionsInspections before closing walls prevent costly reopening later
7InsulationGoes in only after all rough-ins pass inspection
8DrywallCovers mechanical systems once they are approved
9PaintingApplied before flooring to avoid drips on finished surfaces
10FlooringInstalled after painting to protect the finished surface
11Cabinets and countertopsSet after flooring is protected or complete
12Fixtures and finish trimFinal connections made after all surfaces are in place

The scheduling logic here is not arbitrary. HVAC ductwork is the largest and least flexible system in the building. Running it first gives plumbers and electricians room to route around it. Reversing that order forces expensive rerouting or inspection failures.

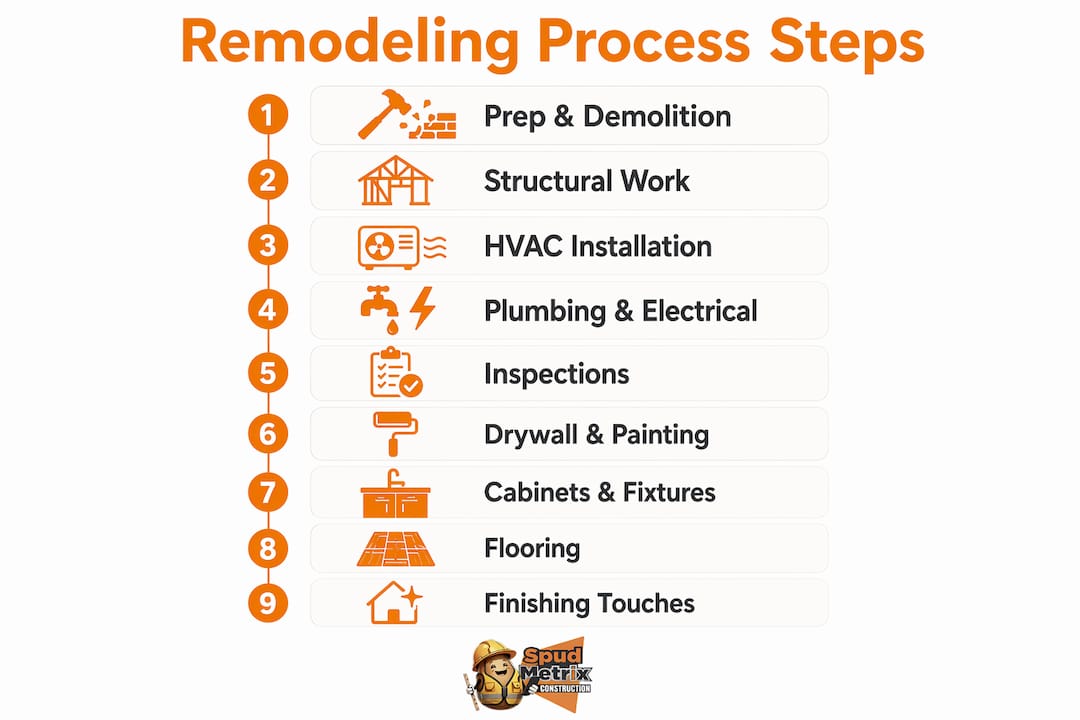

Infographic showing remodeling project step sequence

Pro Tip: Lock your scope completely before submitting permit applications. Changes after permit submission restart the clock and can push your rough-in inspections back by weeks.

How does following the correct sequence save money and time?

Wrong sequencing adds 10–25% to total project costs through rework alone. On a $60,000 kitchen remodel, that translates to $6,000–$15,000 in avoidable waste.

The most common and expensive example is flooring installed before plumbing work is complete. When a pipe needs access, the new floor comes up. The homeowner pays twice for labor and materials, plus the delay while trades reschedule. That single sequencing error can cost more than the flooring itself.

Trade stacking creates a separate problem. When two trades show up to work in the same space at the same time because scheduling was not coordinated, both lose productive hours and one typically has to leave and return. Return visits carry mobilization costs. Those costs accumulate fast on a multi-phase project.

The financial case for correct sequencing comes down to three points:

Pro Tip: Tie every progress payment to a passed inspection or a completed milestone. Payment gating tied to milestones removes the financial incentive for contractors to skip critical steps.

What common mistakes do homeowners make in remodeling sequence?

The most damaging errors share one trait: they prioritize visible progress over correct order. Homeowners want to see results, and that impulse pushes projects out of sequence.

The most frequent mistakes include:

Each of these mistakes is avoidable. The pattern behind all of them is the same: a homeowner or contractor prioritized speed or aesthetics over the physical logic of the dependency chain.

How can homeowners plan and manage remodeling sequence effectively?

Effective sequence management starts before the first contractor sets foot on site. The planning decisions made in the first two weeks of a project determine whether the schedule holds or collapses.

  1. Lock your scope before pricing. A clearly defined remodeling scope prevents change orders that force sequencing restarts. Every change after work begins costs more than the same change made during planning.
  2. Order long-lead items immediately. Cabinetry, windows, and specialty appliances should be ordered the same week permits are submitted. Decision latency on long-lead items is one of the top causes of project delays, and it has nothing to do with labor speed.
  3. Build a 20–30% schedule contingency into each phase. Older homes routinely reveal hidden conditions such as water damage, outdated wiring, or asbestos that require additional work before the sequence can continue. A buffer prevents one discovery from collapsing the entire schedule.
  4. Use milestone-based progress tracking. Map each phase to a specific deliverable: demolition complete, rough-ins passed inspection, drywall hung. Tracking against milestones makes sequencing problems visible early, when they are still cheap to fix.
  5. Communicate sequencing priorities to every trade. Each contractor needs to know what phase precedes theirs and what they must leave ready for the next trade. A detailed remodeling timeline shared with all parties eliminates the “I didn’t know” excuse.

Delays in remodeling projects come more often from permitting wait times, material lead times, and slow homeowner decisions than from slow labor. That means the homeowner’s own speed of decision-making is a scheduling variable. Treat it as one.

Pro Tip: Use your interior remodel planning checklist to confirm every phase is ready before the next trade mobilizes. A five-minute check prevents a five-day delay.

Key Takeaways

The correct remodeling sequence is a physical dependency chain, and following it is the single most effective way to control costs, avoid rework, and keep your project on schedule.

PointDetails
Sequence is a dependency chainEach phase physically depends on the previous one being complete and inspected.
Rework is the biggest cost riskWrong sequencing adds 10–25% to total project costs through avoidable rework.
Inspections gate the scheduleRough-in inspections must pass before walls close to avoid costly reopening.
Long-lead items need early ordersCabinets and windows ordered late add months to the schedule with no construction benefit.
Homeowner decisions drive delaysSlow finish selections and scope changes cause more delays than slow labor.

What I’ve learned from watching projects go sideways

The remodeling sequence is not a contractor preference. It is a physical law. You cannot insulate before the inspector signs off on rough-ins. You cannot paint before drywall. You cannot install countertops before cabinets. The chain is fixed.

What I have seen derail more projects than anything else is not a bad contractor or a surprise in the walls. It is a homeowner who has not made decisions. The tile is not selected. The cabinet color is still “between two options.” The appliance package has not been ordered. Meanwhile, the framing crew finishes, the plumber finishes, the electrician finishes, and everyone sits waiting. Slow homeowner decisions are the largest driver of project delays, and most homeowners do not realize they are the bottleneck.

The second thing I have seen consistently is the belief that design equals planning. A beautiful set of renderings does not tell a contractor what order to do the work. Without a sequenced schedule tied to inspections and milestones, even a well-designed project turns into a coordination mess. The homeowners who finish on time and on budget are the ones who treat the sequence as seriously as the design.

Understanding the dependency chain puts you in a position to hold your contractor accountable. You know what should come next. You know what an inspection gate looks like. You know that flooring before plumbing is a red flag. That knowledge is worth more than any contingency budget.

— Brandon

How Spudmetrix helps Houston homeowners stay on sequence

Spudmetrix works with Houston homeowners and property investors from the first consultation through final walkthrough, with a process built around correct sequencing and transparent milestone tracking.

https://spudmetrix.com

Every Spudmetrix project starts with a free in-home consultation and a detailed written estimate that maps phases in the correct order. Permits and inspections are handled as part of the process, not as afterthoughts. For homeowners who want to understand what belongs in their contract before work begins, the remodeling contract guide covers inspection milestones, payment gating, and scope lock language that protects you at every phase. If you are ready to plan a project the right way, Spudmetrix offers the local expertise and structured process to get it done.

FAQ

What is the correct order for a home remodel?

The standard remodeling sequence runs from demolition through structural work, then HVAC, plumbing, and electrical rough-ins, followed by inspections, insulation, drywall, painting, flooring, cabinets, and finish trim. Each phase must be complete and inspected before the next begins.

Why does remodeling sequence affect cost?

Wrong sequencing forces rework, which adds 10–25% to total project costs. The most common example is flooring installed before plumbing is finished, requiring removal to access pipes and paying for labor and materials twice.

When should I order cabinets and appliances for a remodel?

Order cabinets, windows, and appliances at the same time you submit permit applications. These items carry lead times of 6–14 weeks, and ordering them late is one of the top causes of project delays.

What happens if rough-in inspections are skipped?

Skipping rough-in inspections before closing walls means the inspector will require the wall to be opened after drywall is installed. That creates guaranteed rework costs and schedule delays that could have been avoided entirely.

Do older homes require special sequencing steps?

Yes. Homes built before 1978 require compliance with the EPA’s Renovation, Repair, and Painting Rule when demolition disturbs lead-based paint. This adds specific containment and certified-contractor requirements that must be sequenced before standard demolition proceeds.
