Strategic upgrades raise after-repair value (ARV) because they shift buyer perception and remove the inspection or financing objections that suppress offers and appraisals. When those upgrades align with what local comparable sales support, they translate directly into a higher sale price or refinance value. The three upgrade categories that move ARV most reliably are kitchens, bathrooms, and curb appeal. Each one works on two levels at once: it creates an emotional response that pulls buyers toward full-price offers, and it produces comp-supported evidence that appraisers can use to justify a higher number.
A few practical rules apply before you spend a dollar. Larger remodels like kitchens and bathrooms typically drive the biggest ARV uplift, while cosmetic-only updates help perception but rarely move the needle on their own. Match your finish level to the neighborhood ceiling, and fix major systems before touching anything visible. Leaving a roof leak or failing HVAC unaddressed forces inspection concessions that often cost more than the repair itself.
Quick wins that protect and build ARV:
- Fresh interior and exterior paint in neutral, current palettes
- Updated kitchen hardware, lighting, and cabinet faces (when the layout already works)
- New vanity, fixtures, and tile in bathrooms
- Pressure-washed driveway, trimmed landscaping,
and a new front door - Roof, electrical panel, and HVAC in documented working order before listing
One number to keep in mind: misjudging ARV by $10,000 can cost roughly $7,000–$7,500 in reduced flip profit or refinance proceeds. That margin disappears fast if your upgrade scope is not anchored to real comps.
Table of Contents
- How is ARV actually determined in U.S. markets?
- Which upgrades reliably raise ARV the most?
- What upgrades carry weak or risky ROI?
- How should you prioritize and sequence the work?
- How do you estimate ARV step by step?
- How do upgrades interact with appraisals and lender requirements?
- How Spudmetrix approaches investor projects in Houston
- Key Takeaways
- The case for mid-range finishes over luxury upgrades
- Spudmetrix investor services: your next step toward higher ARV
- Useful sources for ARV research and renovation planning
How is ARV actually determined in U.S. markets?
ARV, or after-repair value, is the estimated market value of a property after all planned renovations are complete. For flippers, it sets the ceiling on what you can pay for a deal and still profit. For BRRRR investors, it determines how much equity a lender will recognize at refinance. The number is not a wish; it is a comp-based estimate that appraisers and the market will either confirm or correct.
The process works like this: an appraiser or investor pulls recent comparable sales from the local MLS, typically within a half-mile radius and sold within the past 90–180 days. Those comps are then adjusted for differences in square footage, condition, bedroom count, and finish level. The adjusted values are averaged or weighted to produce an ARV estimate. Lenders apply their own loan-to-value (LTV) rules on top of that figure, which is why a conservative ARV estimate protects you more than an optimistic one.

With strong comps (multiple nearby, recent sales), ARV estimates typically approximate the eventual appraisal or sale price within a small margin. When the comp set is thin or dated, that margin can widen significantly. That variance is the core reason you need a buffer built into every offer.
Three authoritative resources that shape how ARV is set:
- The Appraisal Foundation sets the Uniform Standards of Professional Appraisal Practice (USPAP) that licensed appraisers follow when valuing residential property.
- Local MLS comps are the primary data source for both investor ARV estimates and formal appraisals; the quality and recency of your comp set determines estimate accuracy.
- Standard lender LTV rules (commonly 70–75% of ARV for fix-and-flip loans) create a hard ceiling on how much of your estimated value a lender will finance.
The neighborhood ceiling concept matters here. Comps are the ultimate arbiter of ARV, and over-improving beyond the neighborhood ceiling commonly reduces ROI. School district quality, lot size, and floor plan set an upper bound that no amount of granite countertops will move. Knowing that ceiling before you scope the project is what separates profitable flips from expensive lessons. You can also explore how remodeling increases home value in more detail to understand which project types have the strongest comp-supported track record.
Which upgrades reliably raise ARV the most?
Kitchens and bathrooms are the primary drivers of perceived condition. A dated kitchen drags perceived value across the whole house; an updated one signals move-in readiness and pulls buyers toward full-price offers. Bathrooms work the same way in a smaller footprint, which means the cost-per-perceived-value ratio is often better there than anywhere else in the house.

Kitchens and bathrooms
For most investor flips, a targeted refresh beats a full gut remodel. Replace cabinet faces or paint existing boxes, swap out hardware and lighting, install a new countertop, and add a tile backsplash. If the layout already works, the highest-return renovation is the one that shifts buyer perception most for the least capital. Reconfiguring plumbing or moving walls adds cost and time without a proportional comp-supported return in most mid-range neighborhoods. A cost-effective bathroom refresh follows the same logic: new vanity, updated fixtures, fresh tile, and good lighting accomplish most of what a full remodel would at a fraction of the cost.
Curb appeal
Low-cost exterior fixes, including pressure washing, painting trim, adding new house numbers, and minor landscaping, frequently give outsized listing and show-quality improvements. Buyers form a price impression before they step inside. A strong exterior photo also drives more showing requests, which increases competitive pressure and supports the asking price.
Curb appeal checklist:
- Pressure-wash driveway, walkway, and siding
- Paint or replace the front door; add updated hardware
- Replace or repaint exterior trim and shutters
- Add low-maintenance landscaping (mulch, trimmed shrubs, seasonal color)
- Replace mailbox and house numbers
- Repair or replace gutters and downspouts
Systems and inspection items
Roof, electrical panel, HVAC, and plumbing do not create emotional excitement, but they do something equally valuable: systems and inspection items increase ARV indirectly by reducing buyer objections and widening the financing pool. A buyer who needs FHA or VA financing cannot close on a property with a failing roof or unsafe electrical. Fixing these items before listing removes that entire class of buyer from the “can’t buy” column and puts them back in the pool, which supports your asking price.

ROI ranges by upgrade category
| Upgrade Category | Typical Cost Range | Estimated ARV Uplift | Notes |
|---|---|---|---|
| Kitchen refresh (cosmetic) | — | Often among the strongest interior returns | Dependent on comp finish level |
| Full kitchen remodel | — | Diminishing returns above neighborhood ceiling | Justify only with strong comp evidence |
| Bathroom refresh | — | Strong cost-per-value ratio | New vanity, tile, fixtures, lighting |
| Full bathroom remodel | — | Moderate; verify with comps | Moving plumbing reduces ROI |
| Curb appeal package | — | High perceived-value lift per dollar | Paint, landscaping, door, pressure wash |
| Roof replacement | — | Indirect; removes financing objections | Protects sale price, not direct uplift |
| HVAC replacement | — | Indirect; expands buyer pool | Required for FHA/VA in many cases |
| Flooring (LVP or hardwood) | — | Moderate; strong visual impact | Pairs well with kitchen/bath refresh |
Ranges are illustrative. Actual returns depend on local comps, market conditions, and project execution.
Pro Tip: When the layout already works and the bones are solid, a cosmetic refresh almost always outperforms a full remodel on ROI. Save the structural reconfiguration budget for properties where the floor plan is a genuine barrier to buyer interest.
What upgrades carry weak or risky ROI?
Many investors mistakenly assume $10,000 of renovation equals $10,000 of value. ARV is dictated by the comp set, not by what you spent. That gap between cost and comp-supported value is where most over-improvement losses happen.
Low-ROI upgrades to approach with caution:
- High-end bespoke finishes (custom cabinetry, imported stone, designer tile) in neighborhoods where comps top out at mid-range finishes
- Swimming pools in non-luxury markets, where they often reduce the buyer pool rather than expand it
- Excessive landscaping or hardscaping beyond what nearby sold properties show
- Home theaters, wine cellars, or specialty rooms with no comp support
- Over-spec appliances that buyers cannot distinguish from standard mid-range models at a showing
Signs you may be over-improving:
- No nearby sold comps at your target finish level within the past 90 days
- Your projected ARV sits more than 10% above the street-level median sale price
- The school district, lot size, or floor plan profile does not support the price band you are targeting
- Your renovation budget is high relative to the purchase price without comp evidence to justify it
- Holding time risk is high and the market is softening
To test whether a specific upgrade is market-justified, pull five recent sold comps and note their finish level. If none of them show the upgrade you are considering, the market is not paying for it yet. That is your answer. Reviewing common renovation mistakes before finalizing scope can save you from the most frequent and costly errors investors make.
How should you prioritize and sequence the work?
Sequencing matters as much as scope selection. Work done in the wrong order creates rework, delays inspections, and extends your holding period, which eats directly into profit. The right sequence protects your timeline and keeps carrying costs predictable.
Step-by-step sequencing framework:
- Structural fixes first. Foundation issues, framing problems, and water intrusion must be resolved before anything else. These affect every trade that follows.
- Mechanical and systems work. Roof, electrical panel, HVAC, and plumbing rough-in. Start with safety and financing items first: roof leaks, unsafe electrical, and failing HVAC deserve priority before cosmetic upgrades because they affect financing and inspection outcomes. Pull permits at this stage.
- Wet areas (kitchens and bathrooms). Tile, plumbing fixtures, and cabinetry after rough-in is inspected and approved.
- Flooring throughout. Install after wet areas are complete to avoid damage from moisture or foot traffic.
- Interior paint. After flooring is protected or complete; coordinate with trim and door installation.
- Fixtures, hardware, and finish work. Light fixtures, cabinet hardware, appliances, and bathroom accessories.
- Exterior and curb appeal. Paint, landscaping, and exterior repairs can often run parallel to interior finish work.
- Staging and photography. The final step before listing; do not rush this.
Sample budget allocation for a 12-week flip
For a mid-range flip in a Houston-area neighborhood, a rough budget priority framework might look like this:
- Structural and systems (roof, HVAC, electrical, plumbing): 30–40% of rehab budget
- Kitchen and bathrooms: 25–35%
- Flooring and paint: 15–20%
- Curb appeal and exterior: 8–12%
- Staging and contingency: 5–10%
These are illustrative ranges. Your actual allocation should be driven by the property’s condition and your comp-supported ARV target. A detailed home renovation budget breakdown can help you map categories to realistic cost bands before you commit to a scope.
Pro Tip: Pull all permits before breaking ground on mechanical work. Unpermitted work discovered during the buyer’s inspection is one of the most common causes of last-minute price reductions and deal collapses. Scheduling inspections as each phase closes also prevents one trade from blocking the next.
How do you estimate ARV step by step?
A reliable ARV estimate follows four steps: find comps, normalize adjustments, set a conservative midpoint, and apply a sensitivity buffer. Skipping any step increases the risk of an appraisal coming in below your target, which can kill a refinance or force a price reduction at closing.

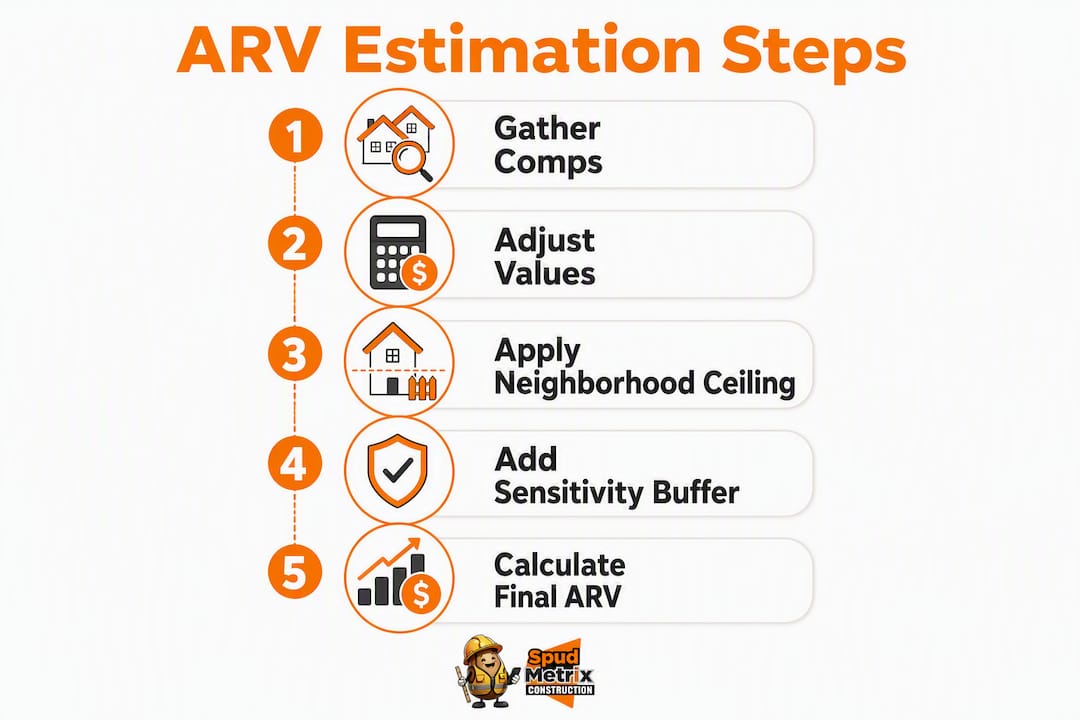

The four-step method:
- Find comps. Pull 4–6 sold properties within a half-mile, sold within the past 90 days, with similar square footage (within 10–15%), bedroom/bathroom count, and lot size. Use MLS data or a licensed agent.
- Normalize adjustments. Adjust each comp for differences in condition, finish level, and features. A comp with an updated kitchen and yours will have a dated one at purchase requires a downward adjustment to that comp’s price.
- Set a conservative midpoint. Average the adjusted values and weight toward the lower end of the range. Appraisers tend to be conservative; your estimate should be too.
- Apply a sensitivity buffer. Run a 5% and 10% appraisal downgrade scenario and confirm the deal still meets your target return. This simple exercise reveals whether your budget and purchase price are resilient to appraisal variance.
Worked example
Assume you are evaluating a 3-bed/2-bath, 1,400 sq ft property in Houston. Your planned upgrades: kitchen refresh, bathroom updates, new flooring, paint, and curb appeal package.
| Comp | Sold Price | Adjusted Value | Notes |
|---|---|---|---|
| Comp A | — | — | Slightly larger lot; adjusted down |
| Comp B | — | — | Near-identical profile |
| Comp C | — | — | Older kitchen; adjusted up for your planned refresh |
| Comp D | — | — | Extra bath; adjusted down |
Average adjusted value: $246,000
Conservative midpoint (weighted low): $243,000
Apply a 5% sensitivity buffer: $243,000 × 0.95 = $230,850 worst-case ARV
If your purchase price plus rehab budget plus holding costs plus profit target still works at $230,850, the deal has margin. If it only works at $246,000, you are one conservative appraisal away from losing money.
Misjudging ARV by $10,000 can cost roughly $7,000–$7,500 in reduced flip profit or refinance proceeds. That is why the sensitivity check is not optional. For a deeper walkthrough of this process, the ARV estimation guide covers how specific construction upgrades map to comp-supported value increases.
How do upgrades interact with appraisals and lender requirements?
Appraisers can only give credit for work they can verify. An upgrade that is not documented, permitted, or visible at the time of appraisal may receive no adjustment at all. For BRRRR investors, this directly affects how much equity a lender will recognize at refinance.
Documentation checklist for appraisal and financing:
- Pulled permits for all structural, mechanical, and electrical work (with final inspection sign-off)
- Contractor invoices itemizing labor and materials by scope
- Before-and-after photos dated and organized by room and trade
- Appliance serial numbers and model documentation
- Contractor warranties and manufacturer warranties for major systems
- A written renovation log with dates, scope changes, and inspection outcomes
Common appraisal pitfalls include incomplete scope documentation (the appraiser cannot see what was done behind walls), reliance on comps that do not match your finish level, and timing issues where the appraisal is ordered before finish work is complete. Schedule the appraisal only after all work is done and the property is clean and staged.
Lenders have their own concerns beyond the appraisal number. Unpermitted work can trigger a lender condition requiring remediation before closing. Systems that are not in working order at the time of inspection can disqualify FHA and VA buyers entirely. For BRRRR investors, a well-documented renovation with permitted work and clean inspection results gives the lender confidence to lend at the full LTV the ARV supports.
Pro Tip: Contact your lender and, if possible, the appraiser before construction begins. Share your comp set and planned scope. This early conversation surfaces any lender-specific requirements (minimum condition standards, required permits) before you have already spent the money.
Understanding remodeling project phases and how permit timing fits into each phase helps you avoid the most common documentation gaps that appraisers flag.
How Spudmetrix approaches investor projects in Houston
Spudmetrix works directly with Houston-area real estate investors and property managers on projects where scope clarity, permit management, and timeline discipline are non-negotiable. The process starts with a free in-home consultation and a detailed written estimate that breaks down costs by trade and phase, with no vague line items. That estimate becomes the foundation for a scoped renovation plan tied to the investor’s ARV target and timeline.
The Spudmetrix investor project process:
- Consult and scope: Free in-home consultation; written estimate with itemized costs and phased timeline
- Permit management: Spudmetrix pulls and manages all required permits, coordinates inspections, and maintains documentation for appraisal packages
- Prioritized construction: Structural and systems work first, then wet areas, then flooring and finishes, following the sequencing framework that protects the investor’s timeline
- Quality closeout: Final walkthrough, punch list completion, and documentation package (invoices, warranties, before/after photos) delivered to the investor
In a recent Houston investor project, Spudmetrix was brought in on a 1970s-era property with deferred maintenance across the roof, electrical panel, and kitchen. The team prioritized the roof and panel first to clear financing objections, then executed a kitchen refresh (new cabinet faces, countertops, backsplash, and lighting) and a curb appeal package (exterior paint, landscaping, and front door replacement). The property appraised in line with the investor’s comp-based ARV target, and the buyer pool included FHA-qualified buyers who would have been excluded before the systems work was completed.
Spudmetrix’s written estimates and permit management remove two of the biggest variables that cause investor projects to miss ARV targets: scope creep and documentation gaps at appraisal time.
Key Takeaways
Strategic upgrades increase ARV when they align with comp-supported neighborhood standards, address inspection and financing objections first, and prioritize kitchens, bathrooms, and curb appeal for maximum buyer perception lift.
| Point | Details |
|---|---|
| Fix systems before cosmetics | Roof, HVAC, and electrical protect the sale price by removing financing objections before any visible work begins. |
| Kitchens and baths move ARV most | A targeted refresh in these rooms delivers the strongest perceived-value return per dollar spent in most mid-range markets. |
| Match the neighborhood ceiling | Comps set the upper bound; over-improving beyond local finish levels produces diminishing returns regardless of spend. |
| Build a 5–10% appraisal buffer | Misjudging ARV by $10,000 can cost roughly $7,000–$7,500 in reduced flip profit or refinance proceeds; always model a worst-case scenario before making an offer. |
| Spudmetrix for Houston investors | Spudmetrix provides free in-home consults, written estimates, permit management, and investor-paced timelines to keep projects on scope and on schedule. |
The case for mid-range finishes over luxury upgrades
The field reality contractors see most often is this: investors who chase luxury finishes in mid-range neighborhoods are not buying higher ARV. They are buying a longer hold time and a narrower buyer pool. The comps do not support the price, the appraiser cannot justify the adjustment, and the buyer who would pay for those finishes is shopping in a different zip code.
Mid-range modern finishes, installed cleanly and on schedule, do something luxury finishes rarely accomplish in investor flips: they make the property feel move-in ready to the widest possible buyer segment. That breadth of appeal is what drives competitive offers and supports the asking price. A kitchen with painted cabinets, quartz countertops, and stainless appliances photographs well, shows well, and appraises well against the comp set. A custom imported-tile kitchen in the same neighborhood does none of those things more effectively, and it costs two to three times as much.
The other trade-off worth naming is scheduling pressure. Luxury materials have longer lead times, more complex installation requirements, and less tolerance for the tight timelines investor projects demand. Mid-range materials are available, installable on schedule, and replaceable if something goes wrong. Speed to market is part of the return calculation, and mid-range finishes protect it.
Spudmetrix investor services: your next step toward higher ARV
Investors who want to convert a well-scoped renovation into a comp-supported ARV gain need a contractor who understands the timeline, the documentation, and the sequencing that appraisers and lenders expect. Spudmetrix offers exactly that for Houston-area projects: a free in-home consultation, a detailed written estimate with no vague pricing, full permit management, and a construction schedule built around investor timelines.

The services cover the full scope of what investor flips and BRRRR projects require: kitchen and bathroom remodeling, flooring installation (hardwood, luxury vinyl plank, tile, and laminate), roofing repair and replacement, interior and exterior painting, and covered patio construction. Every project is managed with permits and inspections handled, so your appraisal documentation package is complete when the appraiser arrives.
Ready to get a written estimate for your next Houston investment property? Book a free in-home consultation with Spudmetrix and get a clear, itemized scope tied to your ARV target. If you want to review what a solid contractor agreement should include before you sign anything, the remodeling contracts guide covers every line item that protects investors.
Useful sources for ARV research and renovation planning
These resources provide authoritative guidance on ARV estimation, remodeling ROI, appraisal standards, and local permitting requirements.
- The Appraisal Foundation — Sets USPAP standards that govern how licensed appraisers value residential property in the U.S.; the primary reference for understanding how appraisers treat renovation scope and documentation.
- Freedom Mortgage: What Is ARV? — Clear overview of ARV mechanics for homeowners and investors, including how lenders use ARV to set loan amounts.
- Real Estate Financial Planner: Calculating ARV — Detailed walkthrough of ARV calculation methods for flip and BRRRR scenarios, including how upgrades affect value estimates.
- Kiavi: What Is ARV? — Covers neighborhood ceiling concepts and the relationship between comps and over-improvement risk.
- Spudmetrix: Estimating After-Repair Value for Renovation Success — Spudmetrix’s own guide connecting construction scope to ARV outcomes for Houston investors.
- Spudmetrix: Interior Remodel Planning Checklist — Step-by-step planning checklist covering sequencing, budget categories, and permit timing.
This article provides general information for real estate investors and is not a substitute for advice from a licensed appraiser, lender, or real estate attorney. Verify current appraisal standards, lender requirements, and local permit rules with the appropriate professionals before making investment decisions.
